How it Works
All projects requesting SMART SCALE funding go through the same quantifiable and transparent prioritization process.
What is SMART SCALE?
Virginia's SMART SCALE (§33.2-214.1) program is about picking the right transportation projects for funding and ensuring the best use of limited tax dollars. It is the method for scoring and recommending projects that meet one or more transportation needs identified in Virginia’s Transportation Plan, VTrans. These needs are referred to as VTrans Mid-term Needs.
Transportation projects are scored using an objective, outcome-based process that is transparent to the public and allows decision-makers to be held accountable to taxpayers. Once projects are scored and prioritized, the Commonwealth Transportation Board (CTB) has the best information possible to select the right projects for funding.
The SMART SCALE Team
The SMART SCALE program is administered by the Office of Intermodal Planning and Investment (OIPI). OIPI partners with the Virginia Department of Transportation (VDOT) and the Virginia Department of Rail and Public Transportation (DRPT) throughout the application process. The team encourages public engagement in developing and implementing the SMART SCALE prioritization process. Public engagement is an integral part of ensuring transparency and accountability.
OIPI works closely with VDOT and DRPT staff during an active round to screen and score incoming applications. All project applications are screened to determine if they meet an identified need in VTrans, the Commonwealth’s long-range transportation plan, and to determine if they meet eligibility requirements.
Between rounds, OIPI seeks feedback from various stakeholders. Lessons learned are utilized to recommend adjustments to the Commonwealth Transportation Board (CTB), and public comment is accepted. Lastly, the team prepares tools and updates policies and guidance for the next round.
The SMART SCALE Process
Virginia’s SMART SCALE process includes five main steps:
- Local and regional applicants submit applications using the SMART Portal.
- OIPI works with VDOT and DRPT to determine whether projects are eligible for funding through SMART SCALE.
- OIPI, VDOT, and DRPT screen for project readiness, ensuring applications meet program requirements.
- OIPI, VDOT, and DRPT score projects using a set of data-driven criteria across six factors. OIPI then prioritizes applications based on the benefit each project provides relative to its cost.
- The Commonwealth Transportation Board programs funding for selected projects after a public review and comment period.
Program Funding
Funding for project prioritization comes from two sources: the construction District Grants Program (DGP) and the High-priority Projects Program (HPP) – both established in 2015 under the Code of Virginia §33.2-358.
The DGP is open only to localities and projects applying for DGP funds compete with other projects from the same construction district. The HPP is open to all applicants, and projects applying for HPP funds compete with projects from across the Commonwealth. A project sponsor may request funding under both programs.
Applications must address needs within certain VTrans Travel Markets to be eligible for DGP or HPP funds. The table to the right shows which Travel Markets are eligible for each funding source.
Certain fund types are not distributed through SMART SCALE but may be used as leveraged funds, reducing the amount of SMART SCALE funds needed and improving its cost-benefit score.
SMART SCALE ensures that projects are evaluated and scored based on an objective, outcome-based process that is transparent to the public and holds decision-makers accountable to taxpayers. The five main steps of the SMART SCALE program are described in greater detail below.
| VTrans Travel Market | High-priority Projects Program | Construction District Grant Program |
|---|---|---|
| Improvement addresses need on Corridors of Statewide Significance | Yes | Yes |
| Capacity need on regional networks | Yes | Yes |
| Improvement to support Urban Development Areas | No | Yes |
| Improvement addresses VTrans specified safety need | No | Yes |
Project Applications
Application Schedule
Eligible applicants may submit project applications according to the SMART SCALE Biennial Schedule. The application process generally follows the schedule below.
Even-Numbered Years
- January through February: Applicants are encouraged to coordinate with VDOT and DRPT prior to applying for SMART SCALE.
- March 1st through March 31st: Applicants create pre-applications with basic project information in the SMART Portal.
- April 1st: Deadline to complete pre-applications. No new applications can be created after April 1st.
- April 1st through May 31st: State staff pre-screen applications to ensure they meet VTrans Mid-term Needs and other eligibility requirements.
- June 1st through July 30th: Applicants refine their applications using screening feedback.
- August 1st: Deadline to submit final application.
- August through December: State staff screen, score, and prioritize
Odd-Numbered Years
- January: SMART SCALE scores and the staff-recommended funding scenario are made public at the January meeting of the CTB.
- February through June: The CTB conducts the Spring Transportation Meetings, engages the public, and makes changes to the funding scenario as appropriate.
- June: The CTB adopts the consensus funding scenario and the final Six-Year Improvement Program.
- July through December: OIPI uses public and stakeholder feedback to refine the application process, scoring methodology, and SMART SCALE policy.

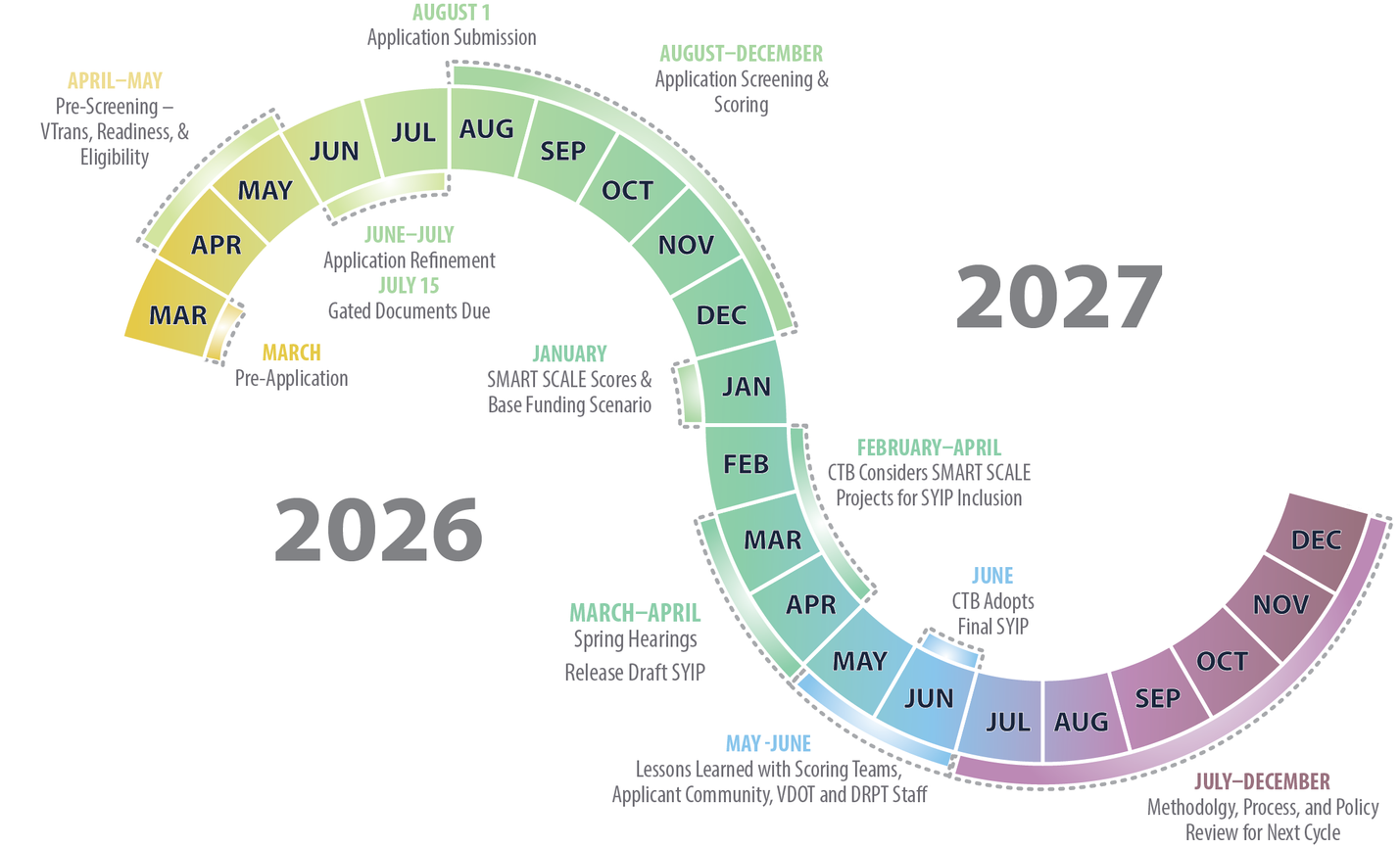

The biennial schedule is summarized in the graphic below.
SMART Portal
SMART SCALE applications are created, submitted, and displayed through the SMART Portal, an application tool used by several funding programs in the Commonwealth. After each round of funding, the Portal provides a public record of the individual project applications and the resulting score for each project. For more information, including a detailed walkthrough for using the Portal, see the SMART Portal User Guide.
The Pre-Scoping Module is a resource within the SMART Portal to assist with project application development prior to creating an application for any SMART Portal funding program. Applicants can build apps in the module before importing them into a SMART SCALE pre-application.
Eligibility Criteria
Who Can Apply?
SMART SCALE applications may be submitted by counties, cities, and towns that maintain their own infrastructure and qualify to receive maintenance payments, pursuant to §33.2-319. Other eligible entities include Metropolitan Planning Organizations (MPOs), Planning District Commissions (PDCs) and public transit agencies. By majority vote, the CTB may also choose to submit up to two projects for evaluation each application cycle.
Applications must be related to projects located within the boundaries of the qualifying entity. However, localities and regional planning bodies may submit applications for projects that cross boundaries with a resolution of support from the affected jurisdiction(s), MPO(s), and PDC(s). Counties are responsible for transportation in towns that do not receive maintenance payments and are encouraged to coordinate with towns and prioritize candidate projects for submission similar to the Secondary Six-Year Plan process.
Though all of these entities may submit projects, applications must address certain VTrans Need Markets depending on the applicant type. The Need Market required for each applicant type is shown in the table below.
| Project Type | Regional Entity (MPOs, PDCs, Transit Agencies) | Locality (Counties, Cities, and Towns) |
|---|---|---|
| Corridor of Statewide Significance | Yes | Yes |
| Regional Network | Yes | Yes |
| Urban Development Area | No | Yes |
| Safety | No | Yes |
Secondary resolutions of support may be required; these requirements are provided in the Readiness Criteria section of this page.
Applicants may submit a limited number of pre-applications and applications in the SMART Portal based on the population thresholds shown in the table below. For a complete list of eligible entities, population data, and the maximum number of applications per tier, download the Final Application Limits FY2028.
| Tier | Localities Population Threshold | MPOs / PDCs / Transit Agencies Population Threshold | Maximum Number of Pre-Applications | Maximum Number of Applications |
|---|---|---|---|---|
| 1 | Less than 200,000 | Less than 500,000 | 5 | 4 |
| 2 | Greater than 200,000 | Greater than 500,000 | 12 | 10 |
The source of population data for cities, counties, and PDCs is the latest University of Virginia Weldon Cooper Center, Demographics Research Group estimates. The data for MPOs and towns is not available from the Weldon Cooper Center and is instead from the latest decennial United States Census. Application limits for transit agencies are determined based on the latest service area population in the National Transit Database (NTD) Transit Agency Profiles. If service area population is not available in the NTD, the latest Census data is used to determine population in jurisdictions served by the transit agency.
Readiness Criteria
In order to ensure that projects can advance to construction, applications must demonstrate a certain level of readiness. At a minimum, all applications must include a description of the project, accurate feature selections, and a detailed project sketch. Additional readiness requirements such as planning studies depend on the project’s scope and are listed in Section 2.4 of the SMART SCALE Technical Guide.
In order to ensure that staff can accurately score projects, it is critical that SMART SCALE applications are consistent.
Resolutions of Support
Applicants must demonstrate that a project has the support of key stakeholders and that the public has had the opportunity to provide comments. Every applicant must include a resolution of support from its own governing body.
Additional resolutions of support may be required depending on the project’s location. Applications submitted by localities, transit agencies, and PDCs that are located within an MPO area must provide a resolution of support from the MPO unless the project is identified in or consistent with the adopted Constrained Long Range Plan. These requirements are summarized in the table below.
If an application includes passenger rail or freight rail features, the submitting entity must provide a letter of support from the stakeholder railroad owner or operator.
| Project Location | Locality Applicant | Transit Agency Applicant | PDC Applicant | MPO Applicant |
|---|---|---|---|---|
| Within MPO(s) |
Yes, from affected MPO(s) |
Yes, from affected MPO(s) |
Yes, from affected MPO(s) |
Yes, from affected MPO(s) |
| Crossing a locality boundary |
Yes, from the affected locality |
No |
No |
No |
| Category C |
30 percent |
20 percent |
15 percent |
0 percent (multiplier) |
| Category D |
40 percent |
10 percent |
10 percent |
0 percent (multiplier) |
Project Scoring
Once it has been determined that a project meets an identified need, is eligible, and is ready, the project is evaluated and prioritized. For each application, 14 scoring measures are calculated across six factor areas: safety, congestion mitigation, accessibility, environmental quality, economic development, and land use. These scores are subjected to a rigorous quality assurance/quality control review to identify any inconsistencies.
After review, the final measure values are normalized from 0 to 100, added together for each factor, and then weighted according to each project’s area type to calculate the project’s benefit score. Each benefit score is then divided by the application’s requested amount to get the final SMART SCALE score for each application.

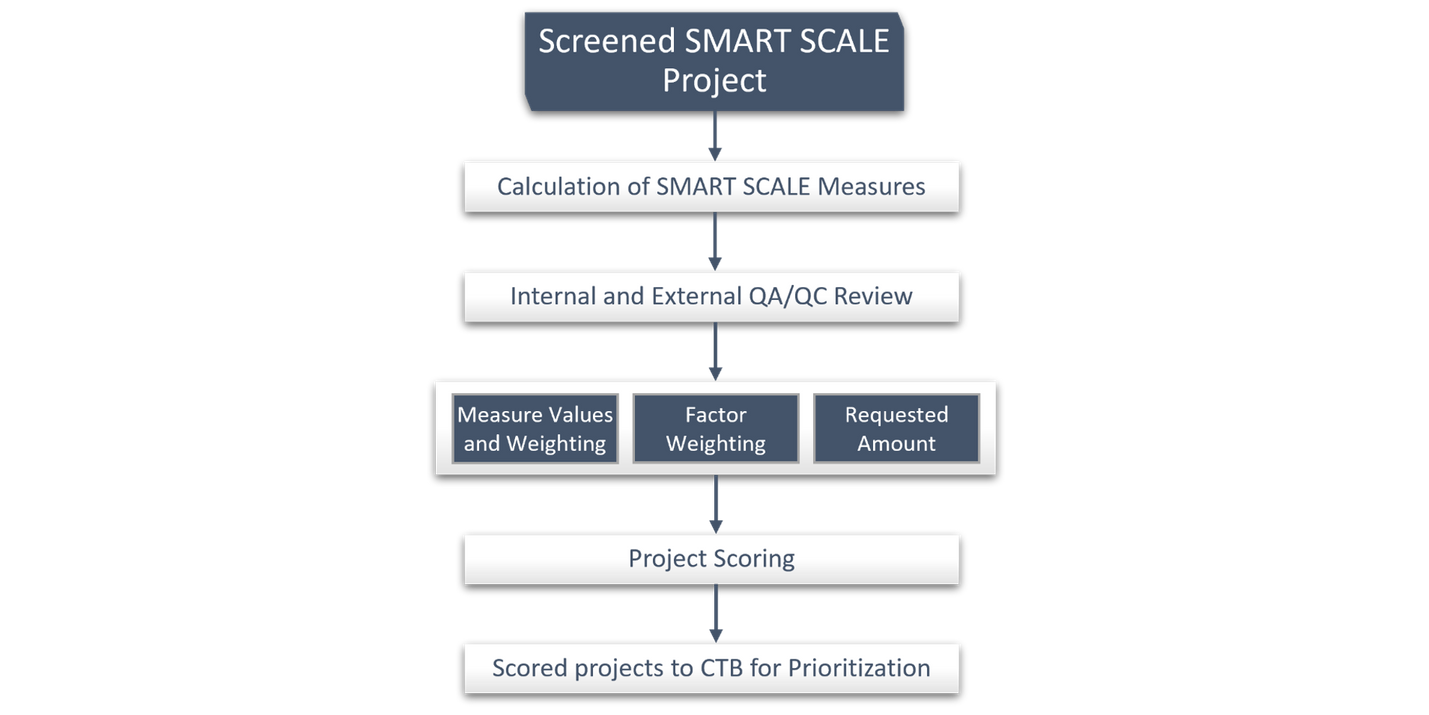

This process is summarized in the graphic below.
Scoring Measures
SMART SCALE utilizes 14 evaluation measures that quantify the benefits of each project for six factor areas as shown in the table below. Each measure is weighted differently within the corresponding factor area.
Safety Factor
| Measure ID | Measure Name | Measure Weight |
|---|---|---|
| S.1 | Equivalent Property Damage Only (EPDO) of Fatal and Injury Crashes | 70 percent (100 percent for transit and transportation demand management projects) |
| S.1 | EPDO Rate of Fatal and Injury Crashes | 30 percent |
Congestion Mitigation Factor
| Measure ID | Measure Name | Measure Weight |
|---|---|---|
| C.1 | Person Throughput | 50 percent |
| C.2 | Person Hours of Delay | 50 percent |
Accessibility Factor
| Measure ID | Measure Name | Measure Weight |
|---|---|---|
| A.1 | Access to Jobs | 60 percent |
| A.2 | Access to Jobs for Disadvantaged Persons | 20 percent |
| A.3 | Access to Multimodal Choices | 20 percent |
Environmental Quality Factor
| Measure ID | Measure Name | Measure Weight |
|---|---|---|
| E.1 | Air Quality and Environmental Effect | 100 percent |
| E.2 | Impact to Natural and Cultural Resources | 0 percent - subtract up to 5 points |
Economic Development Factor
| Measure ID | Measure Name | Measure Weight |
|---|---|---|
| ED.1 | Project Support for Economic Development | 60 percent |
| ED.2 | Intermodal Access and Efficiency | 20 percent |
| ED.3 | Travel Time Reliability | 20 percent |
Land Use Factor
| Measure ID | Measure Name | Measure Weight |
|---|---|---|
| L.1 | Transportation-Efficient Land Use | 50 percent |
| L.2 | Increase in Transportation-Efficient Land Use | 50 percent |
Area Types
Four area types, also called weighting typologies, are used to weight factors according to the unique needs of urban and rural areas. The boundaries of each area type are shown in the map below.
The factor weights for each area type are shown in the table below. For projects that cross multiple area types, OIPI will use the factor weights of the area type covering the majority of the project footprint. The Land Use factor score is not weighted and added to the final score. Instead, it is normalized from 1.0 to 2.0 and multiplied by the sum of the other factors, adding up to 100% to the final benefit score.
| Factor | Safety | Congestion Mitigation | Accessibility | Land Use | Economic Development | Environmental Quality |
|---|---|---|---|---|---|---|
| Category A | 15 percent | 45 percent | 25 percent | 0 percent (multiplier) | 5 percent | 10 percent |
| Category B | 20 percent | 25 percent | 25 percent | 0 percent (multiplier) | 20 percent | 10 percent |
| Category C | 30 percent | 20 percent | 15 percent | 0 percent (multiplier) | 25 percent | 10 percent |
| Category D | 40 percent | 10 percent | 10 percent | 0 percent (multiplier) | 30 percent | 10 percent |
Once all applications have been scored, OIPI develops a staff-recommended funding scenario using a two-step process:
- Step 1: Fund top scoring projects within each district based on SMART SCALE Score eligible for Highway Construction District Grant Program funds using Highway Construction District Grant Program funds until the remaining funds are insufficient to fund the next highest scoring project.
- Step 2: Fund remaining top scoring projects statewide based on SMART SCALE Score for High Priority Projects Program funds using High Priority Projects Program funds until the remaining funds are insufficient to fund the next highest scoring project.
Remaining balances will be reserved to address budget adjustments on selected projects according to the thresholds established in the SMART SCALE Prioritization Process or reserved for allocation in a subsequent round.
The CTB may modify the staff-recommended funding scenario. Additional considerations that may be used by the CTB include:
- Public feedback from Fall Transportation Meetings and Spring public meetings;
- SMART SCALE scores;
- Project segmentation – starting the next phase of a multi-segment roadway improvement, e.g., to complete a major multi-segment project; and
- Applicant delivery performance as reported by Local Assistance Division.
The prioritization process does not require that the CTB fund projects in order of their scores. Further, the CTB is not required to select the highest scoring project. The SMART SCALE process is a means to assist the CTB in evaluating and comparing proposed improvements. The CTB continues to retain final decision-making authority on improvements to be included in the SYIP.

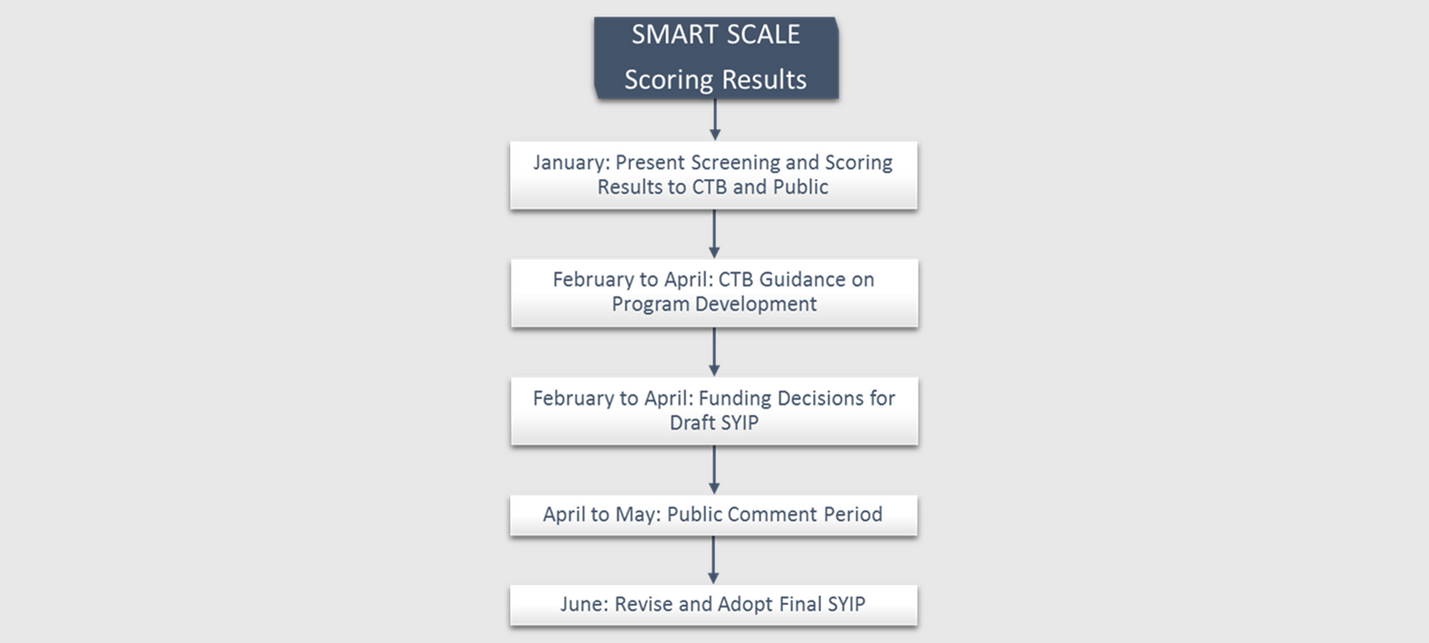

Next, the public has the opportunity to comment on the draft SYIP, including the scoring results for individual projects.
Finally, the CTB takes public comments into account regarding the draft SYIP and approves the final SYIP for implementation in June.
Project Change Process
In general, once a project has been screened, scored, and selected for funding by the CTB, it will remain in the SYIP as a funding priority. Only the CTB can cancel a selected project. A project may be reconsidered for funding in two cases:
- There are significant changes in the scope or cost that alter the original intent or benefit of the project and the CTB’s allocation decision. If the project cost is increased due to a scope change, the applicant is responsible for the additional cost.
- There is a significant reduction in the previously identified local or regional funds leveraged for the project. If the leveraged funds do not materialize, the applicant must pay the difference
If a project’s estimate increases before project advertisement, applicants may request additional funds through the SMART SCALE Project Change Process. OIPI will work with VDOT and DRPT to review the project, including re-scoring if project benefits may be impacted by the change. If the requested funds exceed the thresholds shown in the table below, CTB action is required to approve the budget increase.
| Total Project Budget | Change from Original SMART SCALE Requested Amount |
|---|---|
| Less than $5 Million | 20 percent or greater increase in funding requested |
| From $5 Million to $10 Million | $1 Million or greater increase in funding requested |
| More than $10 Million | 10% or greater increase in funding requested; $5 Million maximum increase in funding |
For a record of previous project changes, see the Project Updates page. For more information about the Project Change Process, see Chapter 4 of the SMART SCALE Technical Guide or review the Project Change Guide.
Project Resubmittal
If a submitted project is not selected for funding during a round, applicants may resubmit the project in the next round.
Once a project is selected for funding, it cannot be resubmitted to address cost increases or loss of other sources of funding. If revenue reductions decrease the amount of actual funding available for a particular SMART SCALE cohort, projects may be delayed and/or revenues from future rounds of SMART SCALE may be used.
Last updated: April 9, 2026
